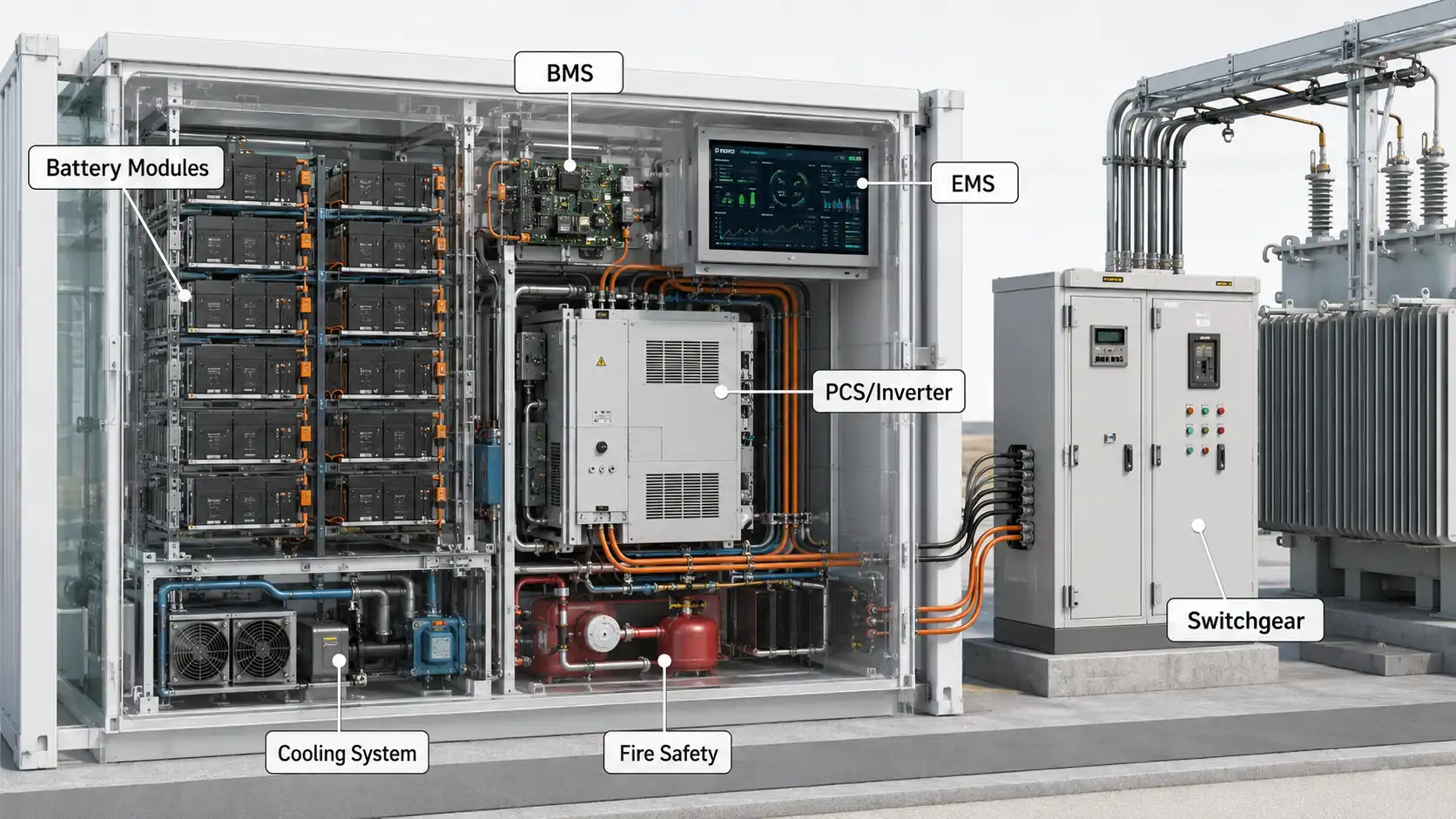

An existing factory can accommodate a battery energy storage system (BESS) if its electrical connection, protection scheme, controls and physical site can support the proposed installation. Before ordering equipment, the project team needs an up-to-date single-line diagram, information on transformers and switchgear, production operating constraints, a proposed BESS connection point and a plan for the electrical tie-in. Any gaps identified during this review should be resolved in the detailed design, not discovered when the cabinets arrive.
Industrial BESS integration in an operating factory is different from designing a system for an empty site. The battery must fit into an electrical network that already supports production, often with limited shutdown windows and established operating procedures. This checklist covers adding a new BESS to an existing facility; it is not a guide to replacing batteries or repowering an existing storage installation.
Can an Existing Factory Accommodate a New BESS?
The first decision is whether there is a feasible electrical and physical connection, not which battery capacity to buy. An apparently suitable area beside a plant may be unusable if the cable route crosses critical process equipment, the proposed switchboard lacks an acceptable connection arrangement, or the facility cannot release the affected circuits for installation.
Start with five questions:
- Electrical connection: Where could the BESS connect, and what is the condition and capacity of the existing equipment at that point?
- Power flow: How would charging, discharging and any permitted export affect the transformer, protection devices and utility connection agreement?
- Site operations: Which production loads cannot tolerate a planned interruption, and which maintenance windows are available?
- Controls: Who will issue dispatch commands, measure site power and handle a loss of communication?
- Installation: Is there an acceptable equipment location with access for delivery, service, electrical cabling and emergency response?
A satisfactory first review means the major constraints are identified and assigned for further engineering. It does not mean that the installation is approved for construction. A formal design and the applicable utility and authority approvals may still be required.
What Electrical Infrastructure Must Be Checked?
The facility's latest as-built single-line diagram (SLD) is the starting document. It should show the utility service, transformers, distribution boards, main breakers, existing generation, major loads and available metering points. Site records should then be checked against the equipment actually installed; older drawings may omit later modifications.
Define the Facility Tie-In Point and the Utility Interface
The factory electrical tie-in point is where the BESS connects to the facility's wiring. It is not necessarily the same as the point of common coupling (PCC) with the utility. Keeping these points distinct matters when specifying current transformers, import/export controls and interconnection protection.
An AC-connected BESS normally interfaces with the plant through a power conversion system (PCS), associated switching and protection equipment. The proposed PCS voltage, rated current, fault response and operating modes have to be evaluated against the existing network. Inverter-based resources can affect fault levels and protection behavior, but their current contribution depends on the equipment and controls; it should not be treated like that of a conventional rotating generator.
Existing transformers and switchboards are not automatically suitable or unsuitable. Engineers should examine thermal loading during charge and discharge, permitted power flow, short-circuit ratings, available connection ways, earthing arrangements and protective-device coordination. A non-export control may be part of an approved design, but software export limits alone should not be assumed to resolve every transformer, protection or utility issue.

| Electrical check | Evidence to obtain | Issue to investigate | Engineering decision |
|---|---|---|---|
| Utility service and PCC | Service agreement, utility correspondence, metering diagram | Import/export restrictions or an additional interconnection review | Confirm the permitted operating envelope and utility process |
| Proposed BESS tie-in | Current as-built SLD, switchboard layout, connection proposal | No suitable feeder position or unacceptable connection arrangement | Confirm the connection location and required modifications |
| Transformers | Nameplates, impedance, loading history, condition records | Charging or reverse power flow may exceed an operating limit | Evaluate loading, protection and any restrictions or upgrade needs |
| Switchgear and breakers | Voltage/current ratings, short-circuit withstand, breaker data | Insufficient ratings, spare ways or physical termination space | Review equipment suitability and replacement or extension options |
| Fault level and protection | Fault study, relay settings, time-current curves, PCS fault data | Changed fault contribution or miscoordination | Complete the relevant protection and coordination studies |
| Earthing and bonding | Grounding drawings, test results, earthing philosophy | Incompatible arrangements or inadequate bonding provisions | Confirm the site and equipment earthing design |
| CTs, meters and controls | Metering SLD, CT ratios/polarity, existing meter specifications | Incorrect net import readings or incomplete control feedback | Define measurement locations, accuracy needs and commissioning checks |
| AC cable routes | Site drawings, measured route lengths, duct/tray information | Congested routes, installation access or thermal/voltage-drop constraints | Review cable design and constructible routing |
For projects involving a utility approval process, the U.S. Department of Energy's distributed energy interconnection checklist provides a useful framework for questions to raise with the utility. Actual interconnection rules depend on the jurisdiction and connection agreement.
Which Factory Loads and Operating Constraints Matter?
Factory load data is needed for more than battery sizing. It identifies when equipment can be isolated, which loads depend on continuous power, whether charging will interfere with production and how controls should respond to operational changes. A 15-minute load profile can be useful for assessing the normal operating pattern, but short-duration events such as motor starts and sensitive process trips may require higher-resolution measurements and equipment records.
Distinguish the proposed operating objective before evaluating the plant's loads. A grid-connected peak-management system does not automatically support a factory during a grid outage. Backup operation needs a separate, approved power architecture, protected-load boundary and transfer/islanding strategy.
| Factory load | Operating constraint | Integration concern | Site evidence |
|---|---|---|---|
| Continuous production lines | Limited tolerance for process interruption | Switchboard work and commissioning may conflict with production | Shift schedule, maintenance plan, affected-circuit list |
| Critical controls, PLCs and IT | Specified ride-through or uninterrupted supply | Transfer behavior, control power and UPS coordination | Critical-load register, UPS drawings and process requirements |
| Large motors and variable-speed drives | Starts, acceleration and regenerative operating events | Transient loading and protection interaction | Motor data, starting arrangements and event records |
| Refrigeration and thermal processes | Temperature limits and restart sequences | Restricted shutdown periods and potential restart peaks | Process operating procedures and load trend data |
| Flexible or scheduled processes | Production timing may be adjustable | Dispatch scheduling must not interfere with plant priorities | Production schedule, interval data and operating constraints |
| Existing solar PV or generators | Shared distribution equipment and existing site controls | Power flow, protection and dispatch coordination | Generation SLDs, inverter and generator manuals, operating philosophy |
If the factory already has solar generation, the project must review how the battery will connect to the existing PV system. The electrical and control interfaces differ between AC-coupled and DC-coupled battery storage. An AC-side addition should not be assumed to require replacement of the existing PV inverters, and a DC-side integration should not be assumed feasible without checking the installed equipment.
How Will BESS Connect to Existing Site Controls?
Electrical compatibility is only one part of the retrofit. The BESS also needs a defined relationship with the factory's meters, PLC or SCADA network, any existing supervisory energy controls and its own BMS and PCS. The central question is not simply whether two systems support the same communication protocol. It is which device is permitted to send each command, what measurements it uses and what happens when a connection fails.
A site-level energy management system may use site meter readings to manage charging and discharging, while the PCS executes power commands subject to its operating limits and the BMS supervises battery limits and protection. The exact division of functions varies by product architecture and project design. A protocol name such as Modbus TCP does not establish that the required registers, permissions and control behavior are compatible.

Control Interface Checklist
| Interface | Confirm before design freeze | Acceptance evidence |
|---|---|---|
| Site power measurement | CT placement, import/export sign convention, meter update rate and accuracy | Approved metering diagram and tested readings |
| EMS to PCS | Permitted setpoints, operating modes, ramp limits and power priorities | Interface specification and functional test results |
| EMS to BMS | Available SOC, alarms and operating limits; which data are read-only | Signal list and verified status mapping |
| Factory SCADA/PLC | Required monitoring, alarms, command ownership and cybersecurity rules | Approved signal list, network design and access permissions |
| Site PV/generator controls | Interactions, export limits, operating priorities and applicable protection | Coordinated operating philosophy and test cases |
| Communications failure | Approved local fallback, alarm behavior, remote command timeout and restart authorization | Manufacturer-supported logic and witnessed fault-response tests |
| Emergency shutdown and interlocks | Required hardwired functions, interface locations and reset conditions | Wiring diagrams and witnessed safety-function tests |
Do not assign a universal communication timeout or assume that every loss of network connectivity must immediately stop the inverter. A site may require a defined ramp-down, a local hold mode or another approved response. The chosen behavior needs to be supported by the actual PCS/EMS controls, coordinated with protection and tested before handover.
Before procurement, the integrator should also obtain an agreed interface responsibility matrix: who supplies the meters, who owns the factory network connection, who configures commands and who investigates faults when two vendors' systems interact.
What Physical Site Conditions Must Be Verified?
A suitable connection on the SLD does not establish that the factory can accommodate the equipment. The site survey should confirm where the system can be placed, how it will be delivered and serviced, and whether the proposed location meets the applicable environmental, structural and fire-safety requirements.

Equipment Location, Foundation and Access
- Structural support: Confirm the installed weight, foundation loads, anchorage requirements and geotechnical or structural capacity using project-specific equipment data.
- Delivery route: Check gates, overhead obstructions, turning space, unloading arrangements and the planned route from delivery vehicle to foundation.
- Maintenance access: Allow the manufacturer-specified access for doors, filters, cooling components, electrical compartments and replacement equipment.
- Cabling: Survey the route to the electrical tie-in, including crossings, conduits, trays, penetration details and areas where factory operations restrict excavation.
- Environment: Review temperature, ventilation, flood exposure, dust, humidity, corrosive atmospheres and site drainage against the proposed equipment specifications.
- Emergency access: Review emergency response routes, fire department access, shutoff locations and relevant facility procedures.
Outdoor battery storage cabinets and larger systems can impose different transport, foundation and service-access requirements. A preliminary layout should be checked against the actual enclosure drawing and installation manual rather than a generic footprint. If the project uses containerized battery storage, verify lifting arrangements, foundation support, cable entry, container access and any separate power conversion or medium-voltage equipment.
Thermal conditions affect location and auxiliary equipment needs. Where heat, airborne contamination or restricted airflow is a concern, evaluate the selected system's environmental operating envelope and BESS cooling arrangement against actual site conditions. Choosing air or liquid cooling does not, by itself, settle the installation requirements.
Fire Safety and Local Approval
Installation separation, fire protection, gas management, emergency access and the required supporting documents depend on the site, system configuration and local authority having jurisdiction. For projects where North American standards apply, UL 9540 addresses energy storage system safety, while UL 9540A is a test method for evaluating thermal runaway fire propagation, not a standalone certification of the complete installed project. Confirm which standards, test reports and installation conditions the local authority and fire engineer require; do not assume one clearance or certification list applies worldwide.
How Can a Factory Plan the BESS Tie-In and Cutover?
For an operating factory, the electrical tie-in may be the most disruptive part of the project. Much of the foundation, equipment positioning and cable-route preparation may be possible while production continues. Work that affects existing energized distribution equipment, however, requires a site-specific work and isolation plan. Whether a shutdown is necessary, and how much of the factory it affects, depends on the electrical topology and the approved work method.
Begin cutover planning while the project is still being designed. Identify affected feeders, production lines, critical control systems and any temporary operating arrangements. Align the proposed work with the plant's maintenance schedule; confirm responsibilities for electrical permits, authorized personnel, utility coordination, testing and production release.
In the United States, OSHA's control of hazardous energy standard sets requirements for covered servicing and maintenance activities. Electrical work must follow the applicable safety rules and the facility's approved procedures. The following matrix is for project planning and acceptance; it is not an energized-work or switching instruction.

Factory Cutover Planning Matrix
| Phase | What to agree before work | Evidence for release | Stop or defer if |
|---|---|---|---|
| Production coordination | Affected circuits, production constraints, shutdown window and responsible contacts | Approved work schedule and load-impact list | Essential production support or temporary arrangements are unresolved |
| Design and materials readiness | Issued drawings, equipment interfaces, cable schedules and installation materials | Reviewed drawings and construction readiness check | Key drawings, devices or connection materials are missing |
| Isolation and access plan | Authorized personnel, isolation boundaries, stored-energy hazards and verification procedures | Approved work and energy-control documentation | Safe access or isolation cannot be established |
| Physical installation | Work boundaries, inspections, quality checks and protection of adjacent plant equipment | Installation inspection records and resolved nonconformities | Conditions differ materially from the approved design |
| Pre-energization review | Completed test plan, updated settings, utility/authority requirements and open-item review | Signed review and required test results | Protection, insulation, earthing or safety issues remain open |
| Commissioning and functional checks | Approved test sequence, operating limits, communications and responsible witnesses | Recorded results against project acceptance criteria | Unexpected operation, alarms or protection responses are not understood |
| Production release and handover | Operating ownership, access permissions, as-built documents and operator instructions | Accepted handover package and closure plan for remaining items | Plant personnel cannot operate or maintain the agreed configuration safely |
The contingency plan should state the conditions under which work stops, who has authority to make that decision and what verified steps are required before the facility can resume normal operation. "Rollback" is not simply closing the previous breaker after a failed test. Restoration must follow the approved electrical and production recovery procedures.
Industrial BESS Site Readiness Checklist
A site readiness review should produce more than a checked box. Each item needs an evidence record, an unresolved engineering question where relevant and a named person responsible for closing it. Responsibilities shown below are suggested review leads; they must be assigned through the actual project scope and contract.
| Readiness item | Evidence needed | Potential constraint | Next action | Review lead |
|---|---|---|---|---|
| Current electrical baseline | As-built SLD, service and distribution equipment schedules | Drawings do not reflect installed wiring | Verify equipment in the field and update the SLD | Facility engineer / electrical designer |
| Connection and power flow | Proposed tie-in, transformer data, import/export permissions | Connection or operating limits not established | Study the point of connection and required utility interface | Electrical designer / utility liaison |
| Switchgear and protection | Ratings, settings, fault information and PCS response data | Protection or equipment suitability not demonstrated | Complete relevant network and coordination studies | Electrical protection engineer |
| Metering | CT locations, meter specifications and one-line measurement layout | Control system may not measure net site flow correctly | Approve metering arrangement and test points | Controls engineer / electrical designer |
| Production operations | Critical-load list, work restrictions and shutdown schedule | Planned tie-in conflicts with continuous operations | Agree affected circuits, window and contingency plan | Plant operations manager |
| Controls and SCADA | Interface list, protocol/register details, network policies | Command conflict or unsupported data exchange | Agree control authority, fallback and interface tests | System integrator / plant controls team |
| Site and civil works | Layout, equipment drawings, access and foundation assessment | Insufficient space, access or structural support | Revise installation layout or complete engineering assessment | Civil designer / site owner |
| Environmental and fire review | Site environmental data, product safety documents, local requirements | Installation or protection measures not yet accepted | Review with relevant designer and authority | Fire/safety engineer / project owner |
| Cutover readiness | Approved work plan, outage agreement and test resources | Unresolved isolation, material or production issues | Close prerequisites before authorizing the tie-in | EPC / facility operations |
| Acceptance and documentation | FAT/SAT plans, witness list, manuals and as-built requirements | System acceptance criteria not defined | Agree test boundaries, records and handover responsibilities | Owner / EPC / equipment supplier |
Items that remain open at the end of the preliminary review should be placed in an action register with an owner and due date. A missing transformer record, unconfirmed SCADA register or unresolved shutdown window should not be treated as a positive readiness finding.
What Should Be Tested Before Factory Handover?
Factory Acceptance Testing (FAT) checks the agreed equipment and controls at the manufacturer's facility or another specified location before delivery. Site Acceptance Testing (SAT) checks the installed system and interfaces against the approved project requirements under actual site conditions. Passing FAT does not replace installation inspections, utility approval or SAT.
The test scope should reflect the system actually purchased, the connection agreement and the approved operating modes. The U.S. Department of Energy's lithium-ion battery storage technical specification template is a useful procurement reference for defining project-specific requirements, but it is not a substitute for the site's commissioning procedures.
| Acceptance area | What to verify | Record to retain |
|---|---|---|
| Electrical installation | Installed configuration, cable terminations, applicable insulation/continuity tests and earthing checks | Inspection and test sheets |
| Protection and safety | Approved protection settings, interlocks, alarms and emergency-stop behavior | Setting files and witnessed test results |
| Metering | Correct polarity, site import/export measurement and controller feedback | Metering verification record |
| Communication interfaces | Required signals, permissions, command priority and loss-of-communication response | Point-to-point test register and fault logs |
| Grid-connected operation | Permitted operating modes, dispatch limits and response to valid commands | Functional test records and trend data |
| Existing generation coordination | Agreed interactions with PV and generators, if installed | Integrated operating test results |
| Backup or islanded operation | Transfer, isolation and load behavior only if the design includes and approves these functions | Approved test protocol and witnessed results |
| Operations handover | Operator training, manuals, alarms, access rights, spares and service contacts | Handover sign-off and final document register |
A normal grid-connected peak-management BESS should not be advertised as capable of supporting an isolated factory unless its PCS, protection, switching architecture and controls have been specifically designed and verified for that duty. Similarly, an alarm test should confirm the documented system response rather than assume every product opens the same internal contactor.
What Documents Should the Factory Send Before Requesting a BESS Proposal?
A reliable initial engineering discussion starts with the factory's existing electrical and operating records. Not every document will be available at the first contact, but uncertainties should be identified rather than replaced with assumptions.
Initial Site Assessment Package
- Electrical one-line: Latest as-built SLD showing utility service, transformers, switchgear, major loads and existing generation.
- Equipment details: Transformer nameplates and available loading information, switchgear schedules, breaker ratings and existing protection records.
- Site demand data: Available interval load profiles and production schedules; provide longer historical coverage where seasonal and process variation matter.
- Proposed objectives: State whether the initial project is intended for peak demand management, solar coordination, backup or another approved duty.
- Physical layout: Available installation area, equipment access, cable-route constraints and any known structural or environmental issues.
- Existing controls: Available meter, SCADA, PLC, solar inverter and generator information, including communication specifications where applicable.
- Operating restrictions: Critical-load register, shutdown limitations and known maintenance windows.
- Utility and approval information: Current service agreement, import/export limits and any previous correspondence about on-site generation or storage.
Information to Resolve Before Detailed Design and Construction
- Verified site measurements and an agreed point of electrical connection.
- Required electrical studies, protection settings and utility approval conditions.
- Foundation and civil design inputs, installation drawings and delivery constraints.
- Approved control architecture, register maps, command responsibility and fault responses.
- Construction work boundaries, outage plan, isolation arrangements and restoration criteria.
- Defined FAT, SAT, commissioning and handover acceptance requirements.
When contacting Polinovel about an existing-factory project, provide the proposed duty, available SLD, target connection voltage, site operating restrictions and known interface requirements. This allows the discussion of commercial and industrial energy storage configurations to start from the site's actual constraints rather than a nominal battery capacity alone.
Frequently Asked Questions
Can a BESS connect to an existing factory switchboard?
Possibly. The answer depends on the connection arrangement, voltage and current ratings, short-circuit withstand, protective devices, available space and the applicable utility and electrical rules. The existing SLD and equipment records must be checked before selecting a tie-in point.
Does the factory need to upgrade its transformer?
Not automatically. Engineers must assess the transformer's present loading, the BESS charging and discharging profile, permitted direction of power flow, protection and condition. Operating restrictions may be an option in some designs, but they cannot replace a required equipment or safety upgrade.
Can installation be completed without stopping production?
Some civil works and equipment preparation may be carried out during normal operations. Electrical tie-in and testing may require isolation of affected equipment. The scope and duration of any outage depend on the plant's distribution design and approved construction method; zero downtime should not be assumed.
What is the difference between the facility tie-in point and the PCC?
The facility tie-in point is where the BESS is electrically connected inside the plant. The PCC is the interface between the customer's installation and the utility system. These may be different locations and can require different protection, control and metering considerations.
Can the new BESS communicate with an existing factory EMS or SCADA?
Only after protocol, signals, command permissions, network requirements and failure responses have been checked. Matching protocol names alone does not guarantee compatibility. Obtain the product interface specification and plan integrated functional testing.
What if the factory already has solar PV or a standby generator?
Existing generation must be included in the electrical and control assessment. Review its connection point, protection, metering, operating modes and interaction with the proposed BESS. Backup or islanded operation should only be included if the equipment and approved design support it.
What needs to be completed before energization and handover?
The project needs the required installation inspections, protection and safety checks, applicable utility approvals, defined commissioning tests and signed acceptance records. The owner should also receive as-built drawings, settings, operating procedures and service information.
Conclusion
Adding BESS to an operating factory begins with the existing installation. Confirm the electrical connection, transformer and switchgear suitability, meter and control interfaces, equipment location and production constraints before finalizing the project design. Treat the tie-in and handover as planned engineering activities with assigned responsibilities and recorded acceptance criteria. A complete site-readiness package helps the factory, integrator and equipment supplier resolve the right questions before procurement and installation.
